With work well under way to deliver the Ashbourne Reborn programme, updated phasing plans have been produced for the Highways and Public Realm project.
Drop-ins took place on Monday 9 June (4:30pm-7pm) and Wednesday 18 June (4:30pm-7pm) at Ashbourne’s Elim Church, Waterside Business Park, DE6 1DG for members of the public and local businesses to ask questions about the delivery of the highways scheme and raise any issues about the delivery of the wider programme.
Derbyshire County Council is responsible for delivering the current Ashbourne Reborn highways work in the town centre. They are prioritising the re-opening of St John Street which is planned by the end of September, and this remains on schedule, however the overall programme is now expected to complete in early November rather than late October.
This information was accurate on 1 August 2025, although it may change over time.

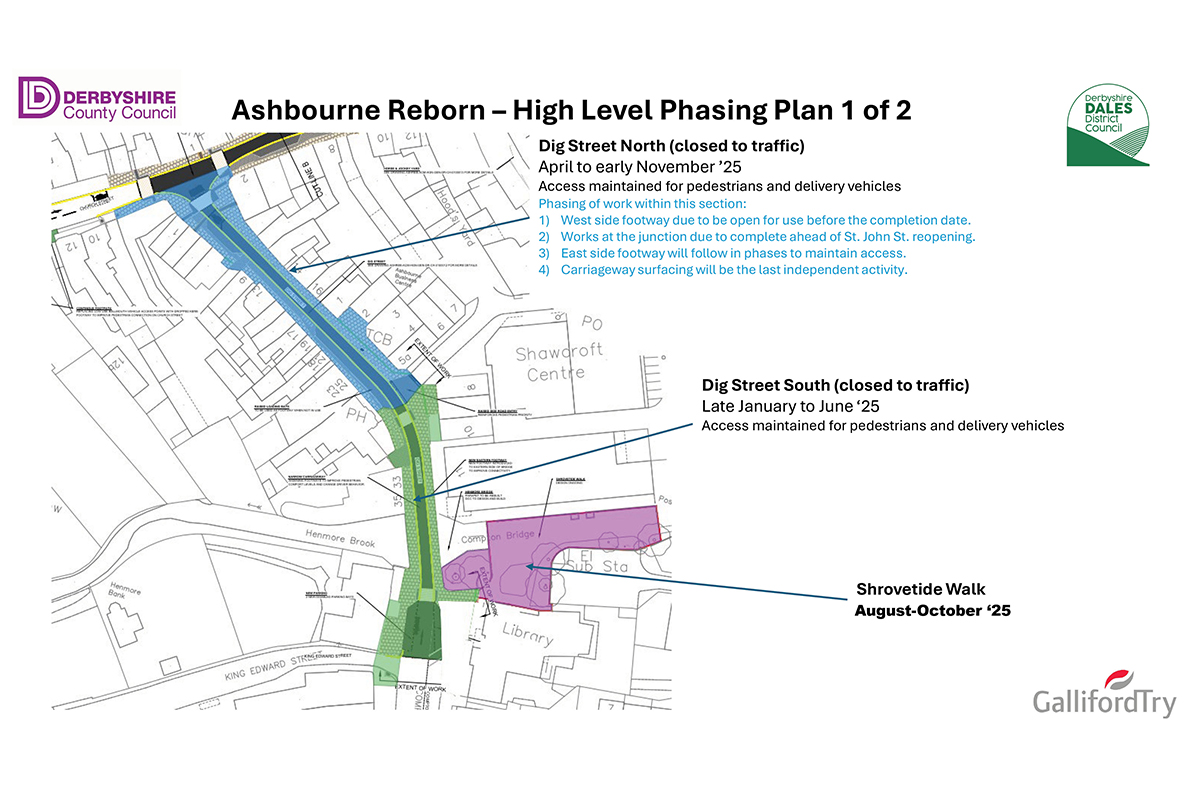

Ashbourne Reborn Phasing Plan 1 of 2

Dig Street North (closed to traffic)
April to early November ’25
Access maintained for pedestrians and delivery vehicles
Phasing of work within this section:
- West side footway due to be open for use before the completion date.
- Works at the junction due to complete ahead of St. John St. reopening.
- East side footway will follow in phases to maintain access.
- Carriageway surfacing will be the last independent activity.
Dig Street South (closed to traffic)
Late January to June ‘25
Access maintained for pedestrians and delivery vehicles
Shrovetide Walk
August to October 2025

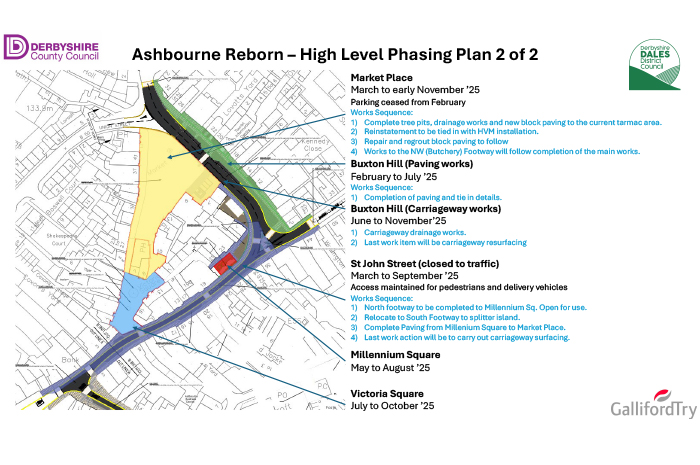

Ashbourne Reborn Phasing Plan 2 of 2

Market Place
March to early November ’25
Parking ceased from February
Works Sequence:
- Complete tree pits, drainage works and new block paving to the current tarmac area.
- Reinstatement to be tied in with HVM installation.
- Repair and regrout block paving to follow
- Works to the NW (Butchery) Footway will follow completion of the main works.
Buxton Hill
Paving works
February to July ’25
Completion of paving and tie in details.
Carriageway works
June to November’25
- Carriageway drainage works.
- Last work item will be carriageway resurfacing
St John Street (closed to traffic)
March to September ’25
Access maintained for pedestrians and delivery vehicles
Works Sequence:
- North footway to be completed to Millennium Sq. Open for use.
- Relocate to South Footway to splitter island.
- Complete Paving from Millenium Square to Market Place.
- Last work action will be to carry out carriageway surfacing.
Millennium Square
May to August ’25
Victoria Square
July to October ’25
